NEXTAS combines a CNC workholding range with engineering support for matching the fixture to the machine and part. Start with the published company and factory records, then review the product, interface and inspection requirements for your job.
The buying process has two stages: review the assessed supplier and facility, then agree the model, drawing, inspection plan and deliverables for your order.
From company records to your project
Use the public records to review NEXTAS’s company and facility. Our team can then help define the configuration, drawings, checks and acceptance records needed for your application.
NEXTAS company and factory records
The legal entity shown on the current About NEXTAS page is NEXTAS CO., LTD. The site records a founding date of March 6, 2009 and a Zhuhai, Guangdong address.
The About page also links to TÜV Rheinland supplier assessment report MIC-ASI2411114, dated August 6, 2024. The report is presented as evidence about the assessed supplier and Zhuhai facility. It is not a blanket product certificate.
| Recorded fact | What it helps confirm | What we confirm for your project |
|---|---|---|

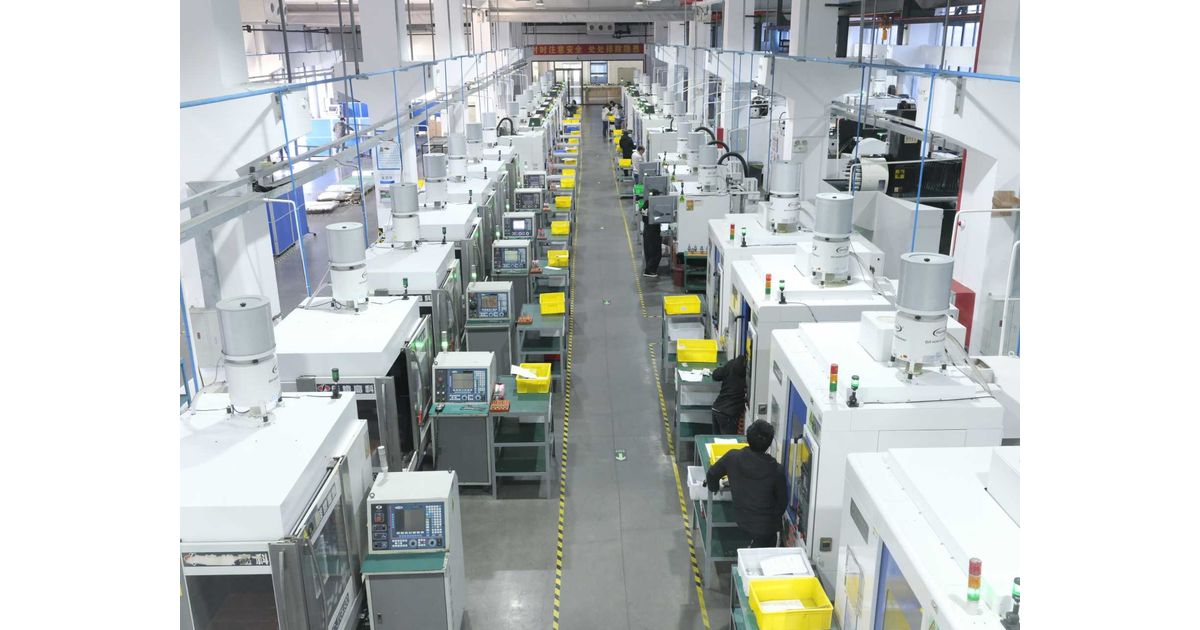

| 43,313 m² assessed plant area | The size recorded for the assessed facility | Available capacity and production schedule |
| Three production lines | The line count in the 2024 assessment | Manufacturing route and assigned production line |
| Seven QA/QC inspectors | The quality staff count in that report | Required checks and project inspection plan |
| 100% visual and functional finished-product inspection | The stated finished-goods control at the assessed site | Dimensional checks and reports to include |
| Raw-material traceability | A recorded traceability control | Material and traceability records to supply |
Share the records and inspection results your project requires. The sales or project team can confirm the manufacturing route and list the agreed documents in the quotation or order confirmation.
Where each NEXTAS route fits
Start with the production task: repeatable fixture changes, multi-side part clamping, a dedicated fixture or automated pallet handling.
- Zero-point systems fit projects that need a repeatable pallet or fixture interface. The receiver, pull stud, load and cleaning plan still need review.
- Self-centering vises fit many multi-side parts. Jaw contact, part shape, clamp force and tool access decide the real fit.
- Custom hydraulic fixtures fit stable part families that need planned location, support, clamp sequence and fluid circuits.
- Pallet changers and automation cells need machine handshakes, payload checks, fault recovery, guarding and a full acceptance plan.
This split also helps procurement compare like with like. A catalogue item, a custom fixture and an integrated cell do not share the same evidence, lead time or acceptance path.
Project inputs that change the answer
A useful review begins with the 2D or 3D part drawing, material, critical features, machine model, table or rotary drawing, and expected batch pattern. Add the current fixture if this is a retrofit.
For automation, include the controller model and software level, door and cycle signals, available floor space, part mass and centre of gravity. State the target operating window, but do not treat that target as a promised result.
If a field is unknown, write unknown. That is better than allowing the supplier to design around a guess.
Proof must follow the selected product
The evidence pack should follow the risk. A standard vise may need a model sheet, interface drawing and inspection record. A custom fixture may also need a design review, clamp sequence, circuit drawing, sample plan and part check. An automation cell adds signal maps, fault tests and site acceptance.
Does the product fit this machine?
Fit depends on the exact machine model and configuration. Compare its table, options, rotary unit, controller version and access limits with the proposed workholding.
For workholding, compare the mounting pattern, locating method, stack height, load, tool clearance and service access. For automation, also compare the exact controller, input and output signals, software options, network method, door control and restart rules.
The supplier should mark what is confirmed, what needs a drawing and what must be tested on site. Avoid a blanket statement that a product fits nearly every CNC brand.
Lead time starts with a defined scope
We confirm the estimated lead time after reviewing the model, quantity, custom work, material, drawing approval, inspection scope and shipping plan.
Ask the quote to show the trigger for the schedule. Is it order date, deposit, drawing approval or material release? Also list the files and records that will be supplied. This prevents a general sales statement from becoming an assumed contract term.
From supplier shortlist to approval
- Shortlist: confirm the legal company, product route and basic capacity evidence.
- Technical review: close the machine, part, interface and acceptance questions.
- Commercial review: align price, scope, lead-time trigger, records and change control.
- Sample or trial: test the highest-risk item with the agreed method.
- Release: approve the final revision and keep the acceptance evidence with the order.
Agree the quotation scope, review the design and inspection plan, then approve the sample and final production revision. Use each stage to resolve the checks listed above.
Building a supplier shortlist?
Find the workholding route for your project
Share your part, machine and the details you have. Our team will help identify a suitable route and confirm the drawings, checks and information needed for a quotation.
Frequently Asked Questions
What is the legal company behind the NEXTAS brand?
The current NEXTAS About page identifies the legal entity as NEXTAS CO., LTD and gives a Zhuhai, Guangdong address. Buyers should still check that the same entity appears on the quotation and order documents.
What does supplier assessment report MIC-ASI2411114 prove?
It records facts about the assessed supplier and Zhuhai facility as of the report date. It does not certify every product or guarantee the quality, documents or capacity for a new order.
What should I send for a CNC workholding review?
Send the part drawing, material, critical features, machine and table data, current fixture, quantity pattern and acceptance needs. Add controller, signals, floor space and part-handling data when automation is in scope.
How can I confirm that a NEXTAS product fits my machine?
Use the exact machine and product drawings. Check the mounting pattern, location method, stack height, load, tool clearance and service access. Automation also needs a controller and signal review.
How does NEXTAS prove quality for my order?
Agree the proof before release. Depending on the project, it may include an approved drawing, model-specific inspection record, sample or tryout, issue log and acceptance test. The quotation should state what is included.
When is lead time confirmed?
Lead time should be confirmed in the quotation after the model, quantity, custom work, approval steps, inspection scope and shipping plan are known. The quote should also state which event starts the schedule.
Find the workholding route for your project
Share your part, machine and the details you have. Our team will help identify a suitable route and confirm the drawings, checks and information needed for a quotation.
Discuss your setup
